The revised capital programme that is being proposed as part of the Annual Plan 2025/26 is still aligned with the direction and goals set by Council in the Three-Year Plan 2024-27.

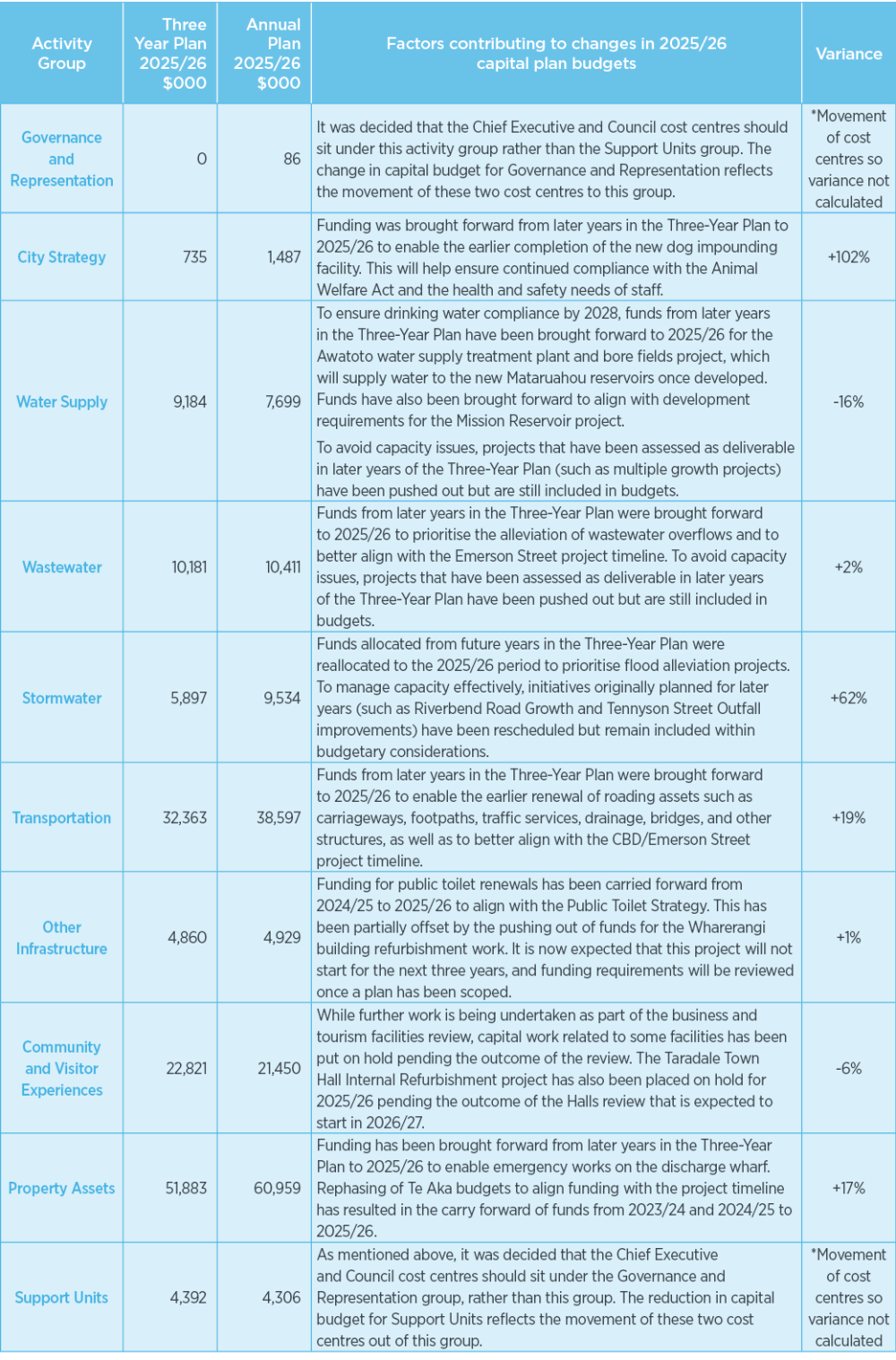

There are a few reasons why we might have to reschedule project budgets. These include: to meet expected compliance requirements from new proposed legislation; to deal with high-risk renewals or upgrades and expiring consents; to better align with project timelines; or to meet contractual obligations. High-level information on some of the changes is outlined on the following pages.
We've provided a number of ways for people to have their say on Napier's Annual Plan.
Disclaimers and Copyright
While every endeavour has been taken by Napier City Council to ensure that the information on this website is
accurate and up to date, shall not be liable for any loss suffered through the use, directly or indirectly, of information on this website. Information contained has been assembled in good faith.
Some of the information available in this site is from the New Zealand Public domain and supplied by relevant
government agencies. cannot accept any liability for its accuracy or content.
Portions of the information and material on this site, including data, pages, documents, online
graphics and images are protected by copyright, unless specifically notified to the contrary. Externally sourced
information or material is copyright to the respective provider.
© Napier City Council
